Why Are NYC Renovations So Complex?

Why are renovations in New York City so complex? Read this blog to find out before you embark on your own NYC apartment renovation.

June 12, 2026

|

8
mins to read
Why Are NYC Renovations So Complex? — Gallery KBNY

Why Are NYC Renovations So Complex?

To dispel some of the sticker shock, we’re breaking down exactly why NYC renovations are so complex. Know what to expect and find out why.

TABLE OF CONTENTS

A full gut renovation is a substantial undertaking in any location. Inside a New York City apartment, a distinct set of forces makes it more involved still. Several of those forces sit outside the apartment itself, in the building and the surrounding city.

About Gallery KBNY

Gallery KBNY is an award-winning, full-service design-build firm specializing in the architecture, interior design, and renovation of apartments, co-ops, condominiums, townhomes, and lofts across Manhattan and Brooklyn. Our integrated team of architects, designers, contractors, and project managers — with a founding partner involved in every project — manages every phase from board approvals and DOB permitting through design and construction. Because architecture, design, permitting, and construction are coordinated under one roof, the process remains streamlined, accountable, and transparent from start to finish. Our work has been recognized by Forbes, The New York Times, Architectural Digest, and Inc., and we have received Houzz Best of Design & Service seven consecutive years, along with 100+ five-star client reviews.


The breakdown below walks through what shapes the cost of an NYC apartment renovation, so you arrive with a clear picture of both the what and the why.

Private Home Versus NYC Apartment The same renovation answers to a different set of conditions once it sits inside a New York City apartment building.
Factor Private Home NYC Apartment
Work Hours 8 to 5, roughly nine usable hours 9 to 4 permitted, near 10 to 3 in practice
Deliveries One bulk drop, stored on site until needed Staged weekly, often 9 to 12 separate drops
Debris Removal Dumpster on site, filled as work proceeds Carried out by hand, bucket by bucket
Plumbing & Electrical A carpenter may handle light tasks Licensed plumbers and electricians for all work
Moving Materials Direct access at grade Reserved elevator, stair carries, or a boom truck through a window
Parking & Access Driveway or low-friction street parking Metered street parking, with tickets priced into the job
Conditions vary by building. A design-build team plans around each of these before work begins.

[#Time]Time limits[#Time]

Apartment buildings hold renovation work to tighter hours than a private home. A standard construction day runs 8 to 5, while most buildings permit work only from 9 to 4, and the exact window varies from one building to the next. Many buildings further restrict noisy work to set hours, which narrows the usable day even more.

The permitted window is not the working window. Each morning opens with protecting the common areas, which can take close to an hour and pushes the real start to around 10. Because the building stays occupied, those protections come down again at the end of every day, taking roughly another hour. A 10 to 3 day becomes the norm where a private home would allow 8 to 5, and the shorter day stretches the schedule and the final cost along with it.

Renovation at 245 East 54th Street in Midtown East by Gallery KBNY
Kitchen from Brooklyn loft renovation in Dumbo. View full renovation before and after.

And because you’re in an apartment building that is occupied by many people, you can’t just leave the protections in the common areas up; they have to come down at the end of each work day, taking up another hour. Now you’re looking at a work day of 10-3, rather than the 8-5 that would be possible in a private home. A shorter work day extends the length of the project, which adds up in the final cost.

[#Elevator]Elevator usage and delivery considerations[#Elevator]

An apartment renovation almost always depends on the building elevator, and that elevator usually has to be reserved, since other residents may be renovating at the same time. Moving materials by elevator adds time, and in some buildings the cab is simply too small for the pieces a project requires.

Picture framing headed to a sixth-floor apartment that will not fit the elevator. The crew either carries it up the stairs, which adds considerable time across a full apartment, or cuts the material to size off-site, a common solution in older buildings. Certain deliveries call for a boom truck to bring materials in through a window, which adds both time and cost.

A recent Chelsea co-op renovation at 107 West 25th Street shows how far that coordination can run. The kitchen centered on an oversized Neolith Calacatta Gold Silk island slab, and the piece was too large for the building elevator. After extensive planning and building approvals, our team opened the elevator shaft on the second floor while the cab waited on the first, then set the slab on top of the cab inside the shaft and rode the elevator roof up to the fourth floor to receive and install it intact. The maneuver looked like a sequence from a Mission: Impossible film, and it carried the centerpiece of the kitchen home with every detail preserved. See our client review from the Chelsea renovation below.

Deliveries also demand careful scheduling. A private home can often take everything at once and store it in the basement until needed. An apartment receives only what the week’s work requires, which can turn a single delivery into nine, ten, or twelve separate ones. Delivering into the city carries its own premium, from minimum order quantities to the cost of navigating traffic and street parking.

Street parking adds time of its own. When the truck has to stop at the end of the block, every material gets walked to the building by hand. A bathroom renovation that takes two weeks in a private home can reach four weeks in an apartment on these factors alone.

[#Building]Building & City Regulations[#Building]

Apartment renovations answer to building rules and city rules at the same time, which sets them apart from work in a private home. Any work involving wet spaces requires waterproofing, which protects the apartment below from water intrusion. Buildings often require replacement of all branch lines, shut-off valves, and vent stacks even where there is no practical need, a step private homes can usually skip.

Private homes can also keep costs down by having a carpenter handle light plumbing, such as swapping a faucet or installing a dishwasher. Apartment buildings hold a firmer line, since all plumbing must be performed by licensed plumbers regardless of how minor the task appears, which raises cost. Electrical work follows the same rule and goes to licensed electricians. Both trades command a premium in New York because they are heavily regulated, plumbing most of all. Aging plumbing can develop gas leaks, so the Department of Buildings and other agencies enforce strict standards that protect every occupant of the building.

A note on city versus building codes: the NYC DOB code does not require a licensed plumber for something as simple as a dishwasher. It does regulate who may perform the technical work of plumbing, including running hot, cold, gas, and waste lines, along with rerouting gas lines.

Management buildings tend to go further, requiring that every piece of plumbing, down to a dishwasher, go through a licensed plumber. Accountability drives that position. A small leak can cause extensive damage, reaching well beyond your apartment to the units below. Alteration agreements exist for this reason. Management companies review and approve a proposed renovation before any work is scheduled, confirming that the contractors and design-build firms in their building carry insurance sufficient to cover whatever might arise.

Living room from renovation at 245 East 54th Street in Midtown East by Gallery KBNY

Approvals themselves reward anticipation, since precedent in a building offers guidance rather than a guarantee. Two recent projects show how quickly the requirements can compound.

At a Tribeca condo on 39 Worth Street, we first proposed rear-wall HVAC condensers, following a setup the unit below had received approval for in an earlier renovation. The building’s reviewing engineer had since ended exterior installations of any kind, which ruled out wall cutouts and facade penetrations. The path forward became a roof-mounted system, coordinated around an upcoming roof replacement and FDNY requirements for rooftop equipment, within the building’s own restrictions and resolved with the building engineer before work proceeded.

At a Classic Seven on the Upper East Side at 170 East 79th Street, the building submission called for an electrical load letter, and each unit carried only 80 amps of service while the client wanted central HVAC. A service upgrade would have meant scaffolding across thirteen floors at a cost above $100,000, so we designed the systems to operate within the existing 80 amps instead, specifying a gas dryer and a gas range alongside lower-demand terminal HVAC units. The tight load math called for a secondary review by a specialized electrical engineer, with detailed voltage-drop calculations running in parallel with the building’s standard review.

Both projects moved forward with their design intent intact. For a fuller account of how boards review major work, see our guide to the co-op board approval process for NYC renovations.

West Village condo renovation at 17 Cornelia Street by Gallery KBN

[#Site]Site conditions[#Site]

This is where the hidden costs of renovating estate-condition pre-war apartments in New York come into play. Pre-war apartments often carry challenging site conditions, among them plumbing untouched for decades, cloth wiring that calls for full replacement, plaster or cement walls, and at times asbestos.

Most full interior renovations involve building, relocating, or removing walls, which in turn means running new circuitry or rewiring the apartment outright. A private home places few limits on how wire is run, often channeled through the ceiling and dropped into the wall. Apartment buildings handle this differently. Ceiling channeling is generally prohibited, and party walls shared with neighbors frequently cannot be channeled either, which confines wiring routes to non-party walls. Channeled walls then need patching and almost always a skim coat to return them to finished condition, which adds meaningful cost. Rewiring a 1,600 sq ft apartment runs close to double the carpentry and electrical cost of the same work in a private home.

Site conditions clearly add time, and added time raises cost. Debris handling compounds the effect. A private home can set a dumpster outside and fill it as the work proceeds, while an apartment offers no such option. Heavy debris travels out by hand, bucket by bucket, to a van or pickup for removal. The time involved often doubles or triples with the scope of the project.

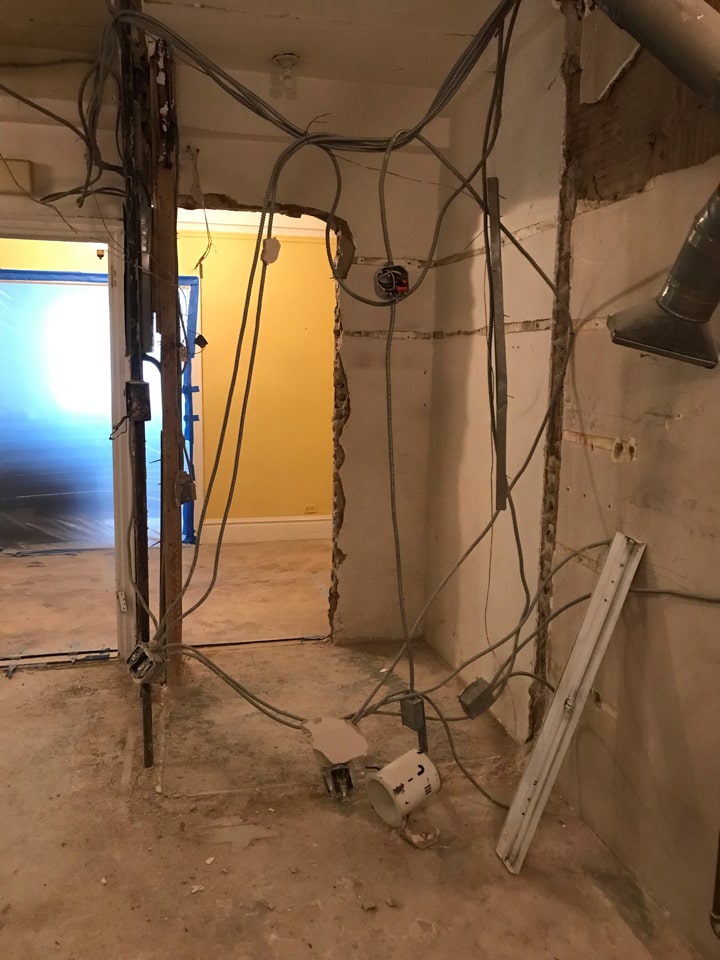

Mid process from Manhattan renovation by Gallery KBNY.

[#Living]Living in the city[#Living]

Street parking adds more than walking time. Parking tickets come with the work, whether from a meter running over or a stop in an off-limits spot. A handful of loading zones may be available, though securing one is far from guaranteed.

Because tickets are a near-certainty on a city project, they get priced into the job from the start. A renovation running three to four months can accumulate a few thousand dollars in parking tickets, accounted for within the budget. UPS even holds an arrangement with the city to settle its tickets at a discounted bulk rate.

Labor costs run higher across the board in the city. Demand for skilled trades and contractors across Manhattan and Brooklyn has outpaced supply in recent years, which lifts costs further.

Add up the building hours, the site conditions, the deliveries, and the parking, and the complexity of an NYC apartment project comes into full view.

Home office from Manhattan condo renovation. View the full renovation before and after.

Elevator usage, site conditions, parking tickets. When you start adding up all the factors that are specific to New York City apartments, the complexity of these projects becomes crystal clear.

What The City Adds To Time And Cost A few representative figures from the work, drawn together for reference. Each varies with the building and the scope.
Factor Effect In An NYC Apartment
Bathroom Renovation About 2 weeks becomes about 4 weeks
Rewiring 1,600 Sq Ft Roughly double the carpentry and electrical cost of a private home
Debris Removal Time 2x to 3x, depending on scope, with hand carry replacing a dumpster
Material Deliveries One bulk drop becomes 9 to 12 scheduled drops
Parking Tickets Up to a few thousand dollars across a 3 to 4 month project, priced into the budget
Figures are illustrative of typical Manhattan and Brooklyn conditions and serve planning rather than quotation.

[#Home]Home Renovation Contractors In New York City[#Home]

At Gallery, we guide your NYC apartment renovation from every angle, from design and planning through a clear account of what each element of the project requires. When an NYC apartment renovation is on your horizon, explore our portfolio of projects or contact us for a consultation.

[#faq]Frequently Asked Questions About Complex Renovations In New York City[#faq]

Why do co-op and condo buildings require a licensed plumber for work as minor as a dishwasher?

City code stops short of that requirement, yet most management companies impose it through the alteration agreement, and the reason is liability rather than code. A single concealed leak can travel through several units below, so buildings insist that licensed, insured trades touch any connection to the plumbing system. The premium on that labor is the price of a clear chain of accountability if water ever finds its way downstairs.

How much can building work-hour restrictions extend a renovation timeline?

A private home can run a nine-hour day, while a permitted 9 to 4 window narrows to roughly five productive hours once daily protection setup and teardown are subtracted. That difference compounds across months of work. A bathroom that finishes in two weeks in a house can reasonably take four in an apartment, and the schedule, more than any single line item, is what carries the cost.

What does an alteration agreement govern, and how does it shape scheduling?

The alteration agreement is the building’s contract for your project. It typically sets insurance limits for the contractor, names the work that requires licensed trades, fixes permitted hours and protection standards, and often requires architect-stamped plans and a compliance deposit. Approval precedes any scheduling, so building the submission early keeps the calendar moving rather than waiting on a board between phases.

Why does rewiring a pre-war apartment cost roughly double the same work in a house?

A house allows wire to run through the ceiling and drop into the wall along the shortest path. Apartments generally prohibit ceiling channeling and often the channeling of shared party walls, which routes wiring through non-party walls only. Each channeled wall then needs patching and a skim coat to return to a finished surface. The added routing and restoration, on top of licensed-electrician labor, is what brings a 1,600 sq ft rewire to about twice the comparable house figure.

How are unavoidable city costs like parking tickets and staged deliveries handled in a budget?

They are forecast rather than absorbed mid-project. A disciplined budget prices in parking tickets across the run of the job, often a few thousand dollars over three to four months, and accounts for staged weekly deliveries in place of a single bulk drop. Naming these line items up front is what keeps a city project predictable rather than subject to a string of surprises.

Manhattan Design-Build

Pre-Purchase Renovation Assessment

Evaluate Your Manhattan Apartment
Before You Buy

Gallery KBNY is an award-winning, full-service design-build firm specializing in the architecture, design, and renovation of apartments, co-ops, condos, townhomes, and lofts across Manhattan and Brooklyn. Our in-house team — with a founding partner involved in every project — manages every phase from board approvals through construction. No outsourcing, no handoffs, no gaps in accountability.

As seen in

| | | |
